Documentation / Scheduling / The Critical Path & float

The Critical Path & float

Every project has one chain of tasks that decides its finish date. If any task on that chain slips, the whole project finishes later. Gantt Excel finds that chain for you every time the schedule changes.

Tasks that are not on the critical path have some breathing room: they can slip a little, or start a little later, without pushing the project’s end date out. That breathing room is called float, and it is also known as slack. Gantt Excel works both out for you from your durations, your dependencies and each resource’s working calendar, and writes the answers into five columns on the sheet.

Prefer to watch? Switching the critical path on, reading its five columns, testing a delay, filtering to it, and finding it in the web report.

01 What the critical path is

The critical path is the set of tasks you cannot afford to let slip. Everything else has float, and the float columns tell you exactly how much room each of those tasks has.

New to the idea? What is the critical path? explains it with everyday examples, and has a short video.

You never enter any of it by hand. The calculation runs after the scheduler has settled every date, so it always reflects the plan as it stands. Change a duration, add a dependency or move a start date and the five columns are brought up to date on the next redraw.

02 The five Critical Path columns

Gantt Excel adds five read-only columns to your chart, just before the Custom 1 column. They are calculated results. Read them, and filter on Critical or Total Float with Filter Tasks, but don’t type into them.

ColumnWhat it tells you
Late StartThe latest the task could start without delaying the project.
Late FinishThe latest the task could finish without delaying the project.
Total FloatHow much the task can slip in total before it delays the project finish. 0 means it’s critical.
Free SlackHow much the task can slip without moving the earliest task that depends on it. A task with nothing depending on it gets its room to the project finish instead. It is normally equal to or smaller than Total Float.
CriticalYes if the task is on the critical path, No if it has room to spare.

A critical task is one whose Total Float is 0, meaning there is no room to move. The rule behind the Critical column is exactly that:

Critical  =  Yes  when  Total Float  =  0

Zero float does not mean the dates match. Total Float counts working time on the task’s own resource calendar, so a task finishing on a Monday can have a Late Finish of Wednesday and still read 0 if that resource works Mondays only, because there is no working day of theirs in between to spend. It is the float number that decides Critical, never the look of the two dates. Section 07 works that case through.

Total Float is never shown as a negative number; the smallest it goes is zero. And Late Start is worked out by stepping back from Late Finish by the task’s own duration, on that task’s own resource calendar, which is why the two always agree with each other.

To see only the critical tasks, use Filter Tasks: pick Critical in Filter on this column: and tick Yes. Filtering on Total Float lists every float value in number order, so you can tick 0, 1 and 2 to see the tasks closest to the critical path as well. Both columns are offered only while they are shown on the chart.

03 Switching the red highlight on

The five columns are always calculated, whether or not anything is red on the chart. The red highlight is a separate, optional thing, and it is controlled by the Show Critical Path tickbox in the Settings dialog: Gantt Excel → Settings → Settings on the ribbon. There is no critical-path button on the ribbon itself.

  • Ticked → the critical path is drawn in red on the chart.
  • Unticked → the chart looks normal and the five columns still show their values.

The columns are kept current in the background even when the highlight is off, so a filter on them is always working from today’s plan.

The critical-path colour defaults to red and can be changed per chart from the colour swatch beside the tickbox. The tickbox has to be on first: click the swatch with Show Critical Path unticked and Gantt Excel says Enable Show Critical Path first to change its color.

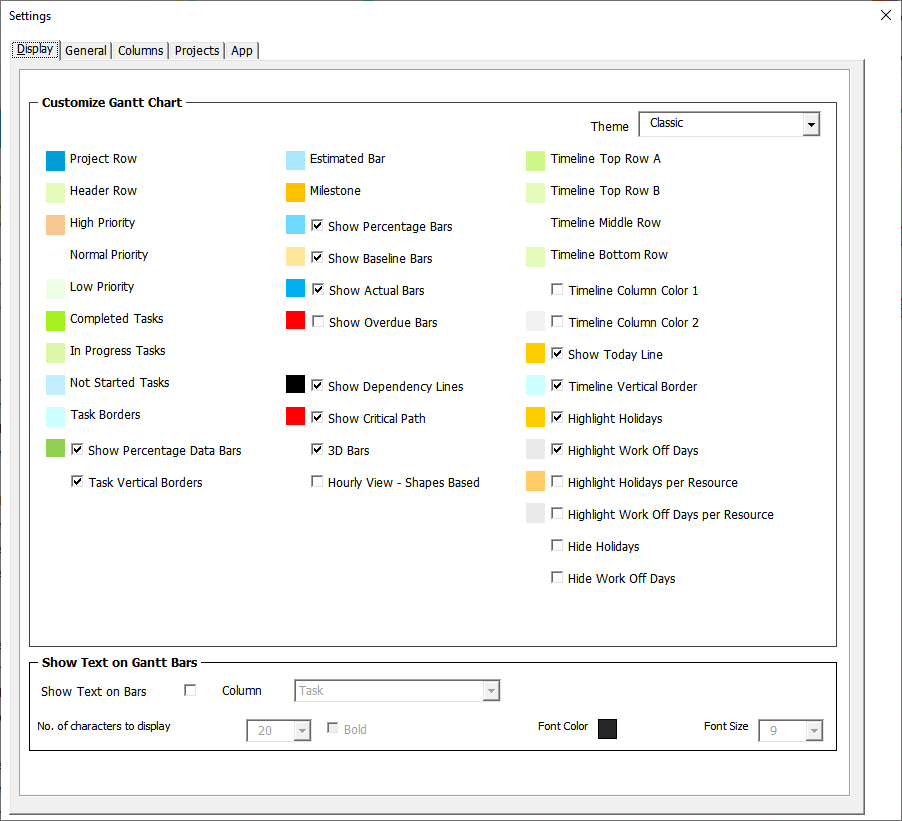

The Settings dialog on the Display tab with the Show Critical Path tickbox ticked and a red Critical colour swatch beside it.
Show Critical Path lives in Settings, not on the ribbon.

04 Reading the red highlight

Two things turn red, and they answer to slightly different rules.

  • Task bars get a red outline when that row’s Critical column reads Yes. Only the outline changes; the bar keeps its own fill colour.
  • Dependency arrows turn red only when the tasks at both ends of the link are critical. An arrow from a critical task into one with float stays its normal colour, because that link is not part of the chain.
Your chartTask barsDependency arrows
Day-based chart (Daily / Weekly / Monthly)🔴 red outline on critical bars🔴 red along the critical chain
Hourly chart, shown in a day-based view🔴 red outline on critical bars🔴 red along the critical chain
Hourly chart, at the hourly view🔴 red outline around the coloured hour cells🔴 red along the critical chain
Hourly chart, at the hourly view, with Hourly View – Shapes Based tickedno outline on task bars; critical milestones keep their red diamond outline🔴 red along the critical chain

The last row is the exception. An hourly chart normally paints its bars by colouring the hour cells themselves, and a critical task gets a red border drawn round that block of cells. Tick Hourly View – Shapes Based in Settings and the bars become drawn objects instead, and that alternative renderer does not outline them. Milestones are unaffected either way. They are drawn as diamonds by the day-based renderer whichever hourly mode you are in, so a critical milestone is still outlined in red. For ordinary tasks the red arrows are then your only visual cue. The five columns are correct in every case.

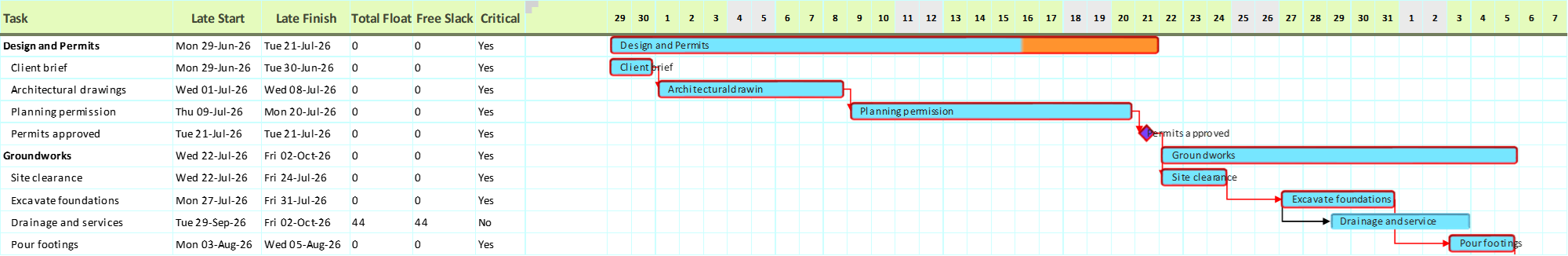

A Gantt chart with Show Critical Path on: critical bars outlined in red, red dependency arrows, and the Late Start, Late Finish, Total Float, Free Slack and Critical columns alongside.
The critical path highlighted in red, with the five calculated columns alongside it.

05 Day-based charts: everything is in days

The unit follows the kind of chart you created, not the view you happen to be looking at. On a day-based chart, meaning any chart that is not an hourly one, durations are in working days, so the critical-path numbers are in working days too, whether you are viewing it daily, weekly or monthly:

  • Total Float and Free Slack are a number of working days.
  • Late Start and Late Finish are shown as dates.

Working days follow the resource’s calendar, so weekends and holidays are skipped, as they are for the bars on the chart.

Worked example: the villa’s first fix

Take the First Fix phase of the Oakfield Villa build. A Monday–Friday week, no holidays in the way. Three trades start the moment the house is watertight, and the plastering waits on the two that hide their work behind the walls:

Watertight → Electrical first fix (5 days) and Plumbing first fix (4 days) → Plastering (6 days)
TaskStartsCriticalTotal Float
Electrical first fixThu 3 SepYes0 days
Plumbing first fixThu 3 SepNo1 day
PlasteringThu 10 SepYes0 days

Both trades are on site from Thursday 3 September, but the electrician needs five days and the plumber only four. The plasterer cannot start until both are out, so plastering begins on Thursday 10 September either way. That gives the plumber one working day of float. Their Late Start reads Friday 4 September: they could turn up a day late and hold nothing up. The electrician has no such slack, so a single day lost on the wiring moves the handover.

Notice what float is not. Windows and doors starts the same morning and carries 18 days of float. It is not unimportant: nothing waits on it, so its slack runs to the end of the project.

06 Hourly charts: everything is in hours

On an hourly chart, durations are measured in working hours rather than days, so the critical-path numbers are in hours too. Switching the chart into a daily view to see a wider span does not change that: the figures stay in hours.

  • Total Float and Free Slack are a number of working hours.
  • Late Start and Late Finish carry a date and a time of day. They pick up their format from the chart’s own start-date column, so they show exactly the same way your other dates do.

“Working hours” respect each resource’s working day. If a resource works 9:00–17:00, a task finishing at 17:00 and the next one starting at 9:00 the following morning are treated as back to back. The overnight gap is not counted as float, because none of it is working time.

Worked example: installation day

The same refit, planned by the hour. One fitter working 9:00–17:00 (8 working hours a day), Monday–Friday:

Deliver and unpack (8h) → Fit units (4h) and Fit splashback (2h) → Connect appliances (4h)
TaskStartFinishCriticalTotal Float
Deliver and unpackMon 09:00Mon 17:00Yes0h
Fit unitsTue 09:00Tue 13:00Yes0h
Fit splashbackTue 09:00Tue 11:00No2h
Connect appliancesTue 13:00Tue 17:00Yes0h

The critical path is Deliver and unpack → Fit units → Connect appliances. Fit splashback finishes at 11:00, but connecting the appliances can’t start until 13:00 because it is waiting on the longer Fit units, so the splashback carries 2 working hours of float. Its Late Start reads Tue 11:00: it could begin two working hours later and still hold nothing up.

07 When linked tasks use different working calendars

Each resource has their own working week, and float is always counted in the working time of the resource doing the task. When two linked tasks are done by resources who work different days, a gap that looks like breathing room on the calendar can be worth no float at all.

A worked example

Suppose the crane the roofers need is only on site on Mondays, so the Roofer works Mondays only, while everyone else works Monday to Friday. Roof structure finishes on a Monday. Roof tiling depends on it, but it is also waiting on other work that runs longer. That sets its start, so it begins on the Thursday.

Roof structure (Mondays only) → Roof tiling (Mon–Fri), starting Thursday

Two clear days sit between them, so it is tempting to read that as slack. Gantt Excel works out that the roof structure could finish as late as the Wednesday without moving the tiling, so that is its Late Finish. It then measures the distance from the Monday to that Wednesday on the roofer’s calendar, and the roofer works neither the Tuesday nor the Wednesday:

TaskFinishesLate FinishTotal FloatCritical
Roof structureMondayWednesday0 daysYes

So the roof structure is on the critical path. You can check it: the roofer’s next working day is the following Monday, after the tiling was due to start, so letting the structure slip by one of the roofer’s own days pushes the tiling, and everything after it, out.

Float is always in the task’s own working time

Float is measured in the working time of the resource doing that task, not in calendar time and not in anyone else’s hours. Suppose the plan above were looser and both of those tasks did have room. Both could show 3 and mean very different things:

TaskResource worksTotal FloatRoughly how much calendar time
Roof structureMondays only3 daysAbout three weeks
Roof tilingMonday–Friday3 daysAbout three days

Both are correct. “Three days of float” means “this task’s resource could put in three more of their working days before anything downstream moves”. If you want to know how much of the calendar that buys, look at the Late Finish date.

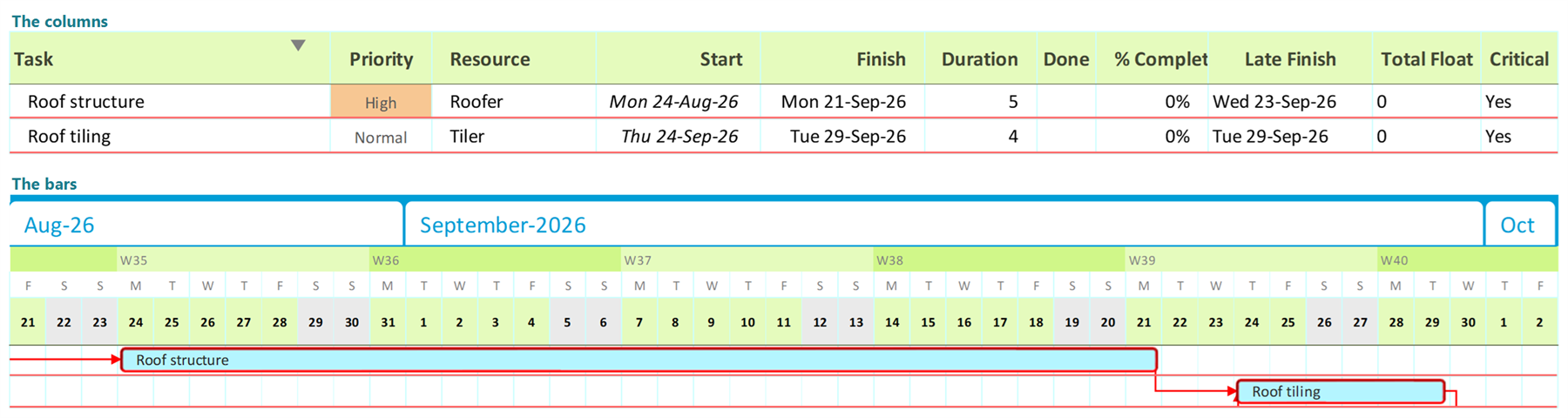

Roof structure, on a Mondays-only Roofer, finishes Monday 21 September with a Late Finish of Wednesday 23 September, Total Float 0 and Critical Yes; Roof tiling, on a Monday–Friday Tiler, starts Thursday 24 September. Both bars are outlined in red.
Two clear calendar days sit between the bars, but they are worth zero working days to a Mondays-only resource, so the roof structure is critical.

08 Summary tasks & milestones

A summary (parent) row doesn’t get its own calculation. Every value on it is taken from the tasks underneath:

  • Critical reads Yes if any task inside it is critical.
  • Total Float and Free Slack show the smallest value among its tasks, the tightest one in the group.
  • Late Start is the earliest Late Start inside it and Late Finish the latest Late Finish, so the row spans the full late window of everything it contains.

On a summary row, Total Float is therefore a summary statistic for the tightest task in the group, so it won’t always line up arithmetically with that same row’s Late Finish. On the individual task rows underneath, the two always agree exactly.

Linking a task to a summary row

You can point a dependency at a summary row rather than at an individual task, and it means “start when everything in that group is finished.” A summary row finishes when the last task inside it finishes, so that is the date your successor waits for.

It works the same way in reverse. If the successor’s deadline pushes back onto the summary row, that deadline belongs to every task inside the group, because the group can only be finished once all of them are. So the whole chain leading into that group is measured against it, and any task inside with no room to spare shows up as critical, exactly as it would if you had linked to it directly.

A milestone is a moment

On a daily chart a milestone sits at the start of its day, before any work that day. A Complete milestone on Mon 12 October is therefore the same instant as the end of Fri 9 October, and the critical path treats it that way. The task finishing on Fri 9 October has no float, because slipping it into Monday would move the milestone. A task linked Finish to Start from a milestone can start on the milestone’s own date, and that is not counted as a day of slack. A summary task that finishes on a milestone counts the same way. Hourly charts keep the ordinary rules.

09 Deadlines

A deadline is a date a task should be finished by: a key date in a contract, a handover you have promised. It is the same idea as the Deadline field in Microsoft Project. Give a task one and its float is measured against that date as well as against the project finish, so you see how much room it has before the deadline.

A deadline never moves the task. Its start, finish and links stay exactly where they are. All it changes is the float of that task, and of every task leading to it.

Setting one

  • In the Task Form, on the Scheduling tab, click Deadline and pick the date from the calendar, or type it. On an hourly chart you can type a time as well. The line beside the box turns red and says how far the task finishes after its deadline, and it updates as you change the dates.
  • Or show the Deadline column (tick it under Columns to show on the Columns tab of Settings; it is hidden until you do) and type the date into the cell. Clearing the cell removes the deadline.

A deadline date means the end of that day: a deadline of Thursday leaves the whole of Thursday. That holds on an hourly chart too, so a task finishing at 17:00 on Thursday meets a deadline of Thursday. On an hourly chart, give a time as well when the deadline is a particular moment. A date that falls on a day off counts as the end of the last working day before it, on the task’s own calendar. Anything that is not a date is refused with Deadline takes a date, or nothing., and the cell keeps its previous date.

Worked example

A Monday–Friday week. Submit the planning notice takes 2 days, Monday 16 and Tuesday 17 November. Nothing waits on it, and the project finishes on Friday 27 November, so without a deadline it has 8 days of float.

DeadlineTotal FloatCriticalWhat you see
none8 daysNoNothing extra
Thu 19 Nov2 daysNoAn outlined arrow at the end of Thursday
Tue 17 Nov0 daysYesThe task finishes exactly on its deadline
Mon 16 Nov0 daysYesMissed by 1 day: the arrow is filled and the Deadline cell turns red

The task’s bar does not move in any of the four rows. A task finishing exactly on its deadline is critical, because any slip at all would miss it.

The arrow on the chart

Every task with a deadline gets a small down arrow on its row, where a bar finishing exactly on the deadline would end. While the task meets its deadline the arrow is outlined in the chart’s link colour. When the task finishes after it, the arrow is filled in the overdue colour. Click the arrow to see the task’s name, the date and, when it is missed, by how much: Deadline: 16/11/2026, missed by 1d, with the date in your chart’s own format.

A missed deadline

When a task finishes after its deadline, its Total Float reads 0 and it is Critical, and so is the chain of tasks driving it. Float is never shown as a negative number, so the amount it is late is shown instead: the Deadline cell turns red, the arrow is filled, and the Scheduling tab of the Task Form says Finishes 1d after its deadline. The amount is working time on the task’s own calendar, so a task due on Friday that finishes on Monday is one day late, not three: the weekend is not working time.

A deadline on a summary row

A summary row can have a deadline too, and it applies to every task inside it, at every level. “The first fix must be finished by Friday” is the same as giving each task in the first fix that deadline. A task with an earlier deadline of its own keeps the earlier one. The summary row is the one marked as missed when any task inside it finishes late.

10 Quick reference

Day-based chartHourly chart
Total Float / Free Slack unitWorking daysWorking hours
Whose working time is it measured in?The task’s own resource, so a wide calendar gap can still count as zero (section 07)
Late Start / Late FinishDateDate and time
Critical bars outlined in red✅✅ except with Hourly View – Shapes Based on
Critical arrows turn red✅ both ends must be critical✅ both ends must be critical
Columns calculated with the highlight off✅ always✅ always
You edit these columnsNever; they’re calculatedNever; they’re calculated
A deadline date meansThe end of that dayThe end of that day, or the time you give
A missed deadlineTotal Float 0, Critical, the Deadline cell red and the arrow filled (section 09)

11 Common questions

Two tasks both say Yes and seem to run in parallel. Is that a mistake?
No. A project can have more than one critical path. If two chains are equally tight, every task on both is marked critical.
A task shows Critical = Yes but I expected it to have float.
The rule is Critical = Yes when Total Float is 0, nothing else. So look at the Total Float column: if it reads 0, the task really has no room, and something in the chain is holding it exactly where it is. The two columns can never disagree. If there is visibly a gap on the calendar after that task, check whose calendar it sits on. A gap that spans days its resource does not work is worth nothing to them, as in section 07. On a daily chart, also check whether the plan closes on a milestone: the task finishing on the last working day before it has no float, because the milestone counts as the end of that day.
A task shows float but I expected it to be critical.
Two common causes, both correct behaviour. Either the task it feeds is being held up by a longer chain arriving from somewhere else, so this one has room to spare, like Plumbing first fix in section 05. Or the task has nothing depending on it at all, in which case its room runs all the way to the project finish. Either way, check the Late Finish date: it tells you the latest this task could actually run.
I used a negative lag (a lead) so a task can start before its predecessor finishes.
That’s supported, and the float figures account for it: a lead doesn’t create any artificial breathing room. A tight chain stays fully critical right through a lead link. The four link types and their lags are covered in the Dependencies guide.
Nothing turns red even though tasks show Critical = Yes.
Check three things, in this order. Is Show Critical Path ticked in Gantt Excel → Settings? Are your groups collapsed? The highlight is suppressed while rows are hidden by grouping. And on an hourly chart, is Hourly View – Shapes Based ticked? With that on, the task bars are not outlined; only the arrows and any critical milestone diamonds turn red.
The columns look empty on an older chart.
Charts created before this feature gain the five columns automatically the first time something touches them: make any edit to the schedule, or open Settings once, and they appear. Reopening the workbook on its own will not do it, because nothing recalculates until something changes. They are inserted immediately before the Custom 1 column, so your own custom columns stay to the right of them.
